Construction WIP Schedule Excel Template (Over/Under Billing & ASC 606 Percentage of Completion)

Reviewed by SheetAtlas Senior CPA & Technical Accounting Desk Compatible with Excel 2016 / 2019 / 2021 / 365 & Google Sheets 100% Unlocked Formulas (Zero VBA Macros)
This Construction WIP (Work-in-Progress) Schedule Excel Template (.xlsx) automates monthly job-by-job revenue recognition under the US GAAP ASC 606 (and IFRS 15) Cost-to-Cost Percentage of Completion method. By entering Original Contract Values, Approved Change Orders, Costs Incurred to Date, Estimated Costs to Complete (ETC), and Progress Billings to Date, the workbook dynamically calculates % Complete, Earned Revenue to Date, Underbillings (Costs & Estimated Earnings in Excess of Billings — Current Asset), Overbillings (Billings in Excess of Costs & Estimated Earnings — Current Liability), and balanced month-end WIP adjusting journal entries.
LIVE EXCEL PREVIEW (3 TABS)

01_WIP_Over_Under_Schedule — Interactive Spreadsheet

G12fx
910000
#ABCDEFGHIJKLMN
1CONSTRUCTION WORK-IN-PROGRESS (WIP) SCHEDULE — ASC 606 OVER / UNDER BILLING
2Surety Bond & CPA Audit Standard (ASC 606 Cost-to-Cost Method) | Teal-Tinted Cells = Editable Inputs | Automatic Over/Under Billing & Margin Analysis
3
4Contractor Legal Entity:Vanguard Civil & Mechanical Contractors Inc.Revenue Recognition Method:ASC 606 Cost-to-Cost InputReporting Period Ending:2026-03-31
5Surety Carrier / Bond Agent:Travelers Casualty & Surety Co. of AmericaSingle / Aggregate Bond Limit:$25M / $75M Bonding LinePrepared By (Construction CFO):D. Sterling, CPA, CCIFP
6WIP Workpaper Reference:WP C-200 (Contract Assets & Liabilities)Minimum Target Gross Margin:External CPA Audit Firm:Crowe Construction LLP
7
8TOTAL REVISED CONTRACT BACKLOGEARNED REVENUE TO DATE (ASC 606)PROGRESS BILLINGS TO DATEUNDERBILLINGS (CIEB ASSET)OVERBILLINGS (BIEC LIABILITY)
9$0$0$0$0$0
10
11Job #Active Construction Project NameOriginal Contract ($)Approved COs ($)Revised Contract ($)Cost to Date ($)Est Cost to CompleteTotal Est Cost ($)% CompleteEarned Revenue ($)Billed to Date ($)Underbilled Asset ($)Overbilled Liab ($)Est Margin %
1226-101Mercy Regional Hospital MEP Central Plant$0$00.0%$0$0$00.0%
1326-102I-95 Highway Overpass Structural Concrete$0$00.0%$0$0$00.0%
1426-103Apex Semiconductor Cleanroom Ductwork$0$00.0%$0$0$00.0%
1526-104Metro Transit Maintenance Facility Electrical$0$00.0%$0$0$00.0%
1626-105Harborfront Cold Storage Warehouse Slab$0$00.0%$0$0$00.0%
1726-106Oakridge High School Science Wing Addition$0$00.0%$0$0$00.0%
1826-107Municipal Water Treatment Pump Station #4$0$00.0%$0$0$00.0%
1926-108Northgate Logistics Park Site Utilities$0$00.0%$0$0$00.0%
2026-109Downtown Federal Courthouse Chiller Retrofit$0$00.0%$0$0$00.0%
2126-110Riverside Multi-Family Podium Deck Framing$0$00.0%$0$0$00.0%
22TOTAL ACTIVE WIP PORTFOLIO$0$0$0$0$0$00.0%$0$0$0$00.0%

Free Instant Download

No email signup • Unlocked formulas

xlsx
Microsoft Excel Workbook (.xlsx — Unlocked Formulas)
Size: 12 KB • Microsoft Excel & Google Sheets
Virus-scanned • Zero macros (.xlsx)SheetAtlas.com

Built-In Excel Formulas & Calculation Logic

Unlocked native Microsoft Excel functions pre-programmed inside this workbook:

ASC 606 Cost-to-Cost Percentage of Completion (%)
=IFERROR(MIN(1, F12/H12), 0)

Divides actual job Costs Incurred to Date (Column F) by Total Estimated Cost at Completion (Column H = Cost to Date + Estimated Cost to Complete), capped at 100.0%.

Cumulative Earned Revenue to Date
=ROUND(E12*I12, 0)

Multiplies the Revised Contract Price (Original Contract + Approved Change Orders in Column E) by the calculated Percentage of Completion (Column I) to determine GAAP earned revenue.

Underbilling (Costs & Estimated Earnings in Excess of Billings — CIEB)
=MAX(0, J12-K12)

Triggers when Earned Revenue to Date (Column J) exceeds Progress Billings to Date (Column K), recording a Current Contract Asset on the contractor's balance sheet.

Overbilling (Billings in Excess of Costs & Estimated Earnings — BIEC)
=MAX(0, K12-J12)

Triggers when Progress Billings to Date (Column K) exceed Earned Revenue to Date (Column J), recording a Current Contract Liability (deferred construction revenue) on the balance sheet.

US Letter / A4 Landscape (Fit to 1 Page Wide)

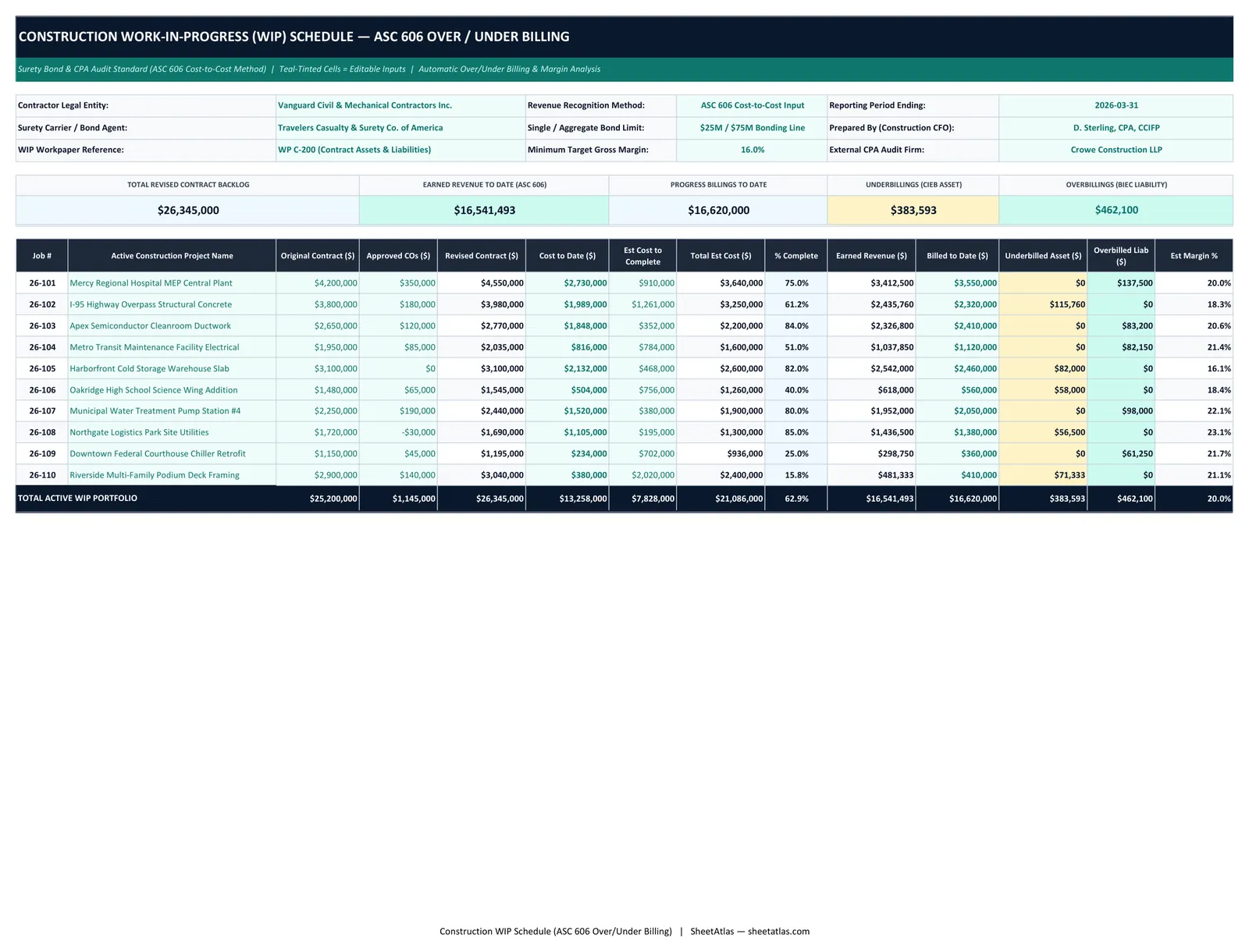

Preview of Construction WIP Schedule Excel Template (Over/Under Billing & ASC 606 Percentage of Completion)
File: Construction_WIP_Over_Under_Billing_Schedule.xlsx Download Full .XLSX →

Overview & Industry Standard Alignment

For commercial general contractors, specialty trade subcontractors, and heavy civil builders, billing a client via AIA G702/G703 progress applications rarely matches true physical project completion. Recognizing revenue strictly on cash or progress invoices distorts monthly gross margins and violates US GAAP ASC 606 and surety bonding covenants. This Construction WIP Schedule Excel Template (.xlsx) provides the exact 14-column Work-in-Progress report required by construction CPAs (CCIFPs), surety bond underwriters, and commercial bank lenders. Tab 01 tracks Original Contract Value, Approved Change Orders, Revised Contract Total, Cost to Date, Estimated Cost to Complete (ETC), Total Estimated Cost, % Complete, Earned Revenue, Progress Billings, Underbillings (CIEB Asset), Overbillings (BIEC Liability), and Estimated Gross Margin %. Tab 02 automatically translates the portfolio totals into a balanced Month-End Over/Under Billing Adjusting Journal Entry, while Tab 03 provides an ASC 606 and Surety Underwriting interpretation guide.

Practical Operational Use Cases:

Quarterly Surety Bond Underwriting Submissions

Deliver a clean, CPA-formatted WIP schedule to your surety bond agent to support single and aggregate bonding capacity increases.

Monthly Construction Financial Close (ASC 606 Compliance)

Adjust unadjusted AIA progress billings to true GAAP Earned Revenue using the automated CIEB / BIEC journal entry on Tab 02.

Early Detection of Job Profit Fade & Underbilling Risk

Spot jobs where Estimated Cost to Complete is rising and chronically underbilled jobs where unapproved change orders are straining cash flow.

Bank Line-of-Credit & External CPA Audit Reviews

Provide commercial lenders and construction auditors with a reconciled schedule tying directly to Balance Sheet Contract Assets (GL 1380) and Liabilities (GL 2380).

Designed For:

Construction CFOs, Controllers & CCIFPs: Automate monthly ASC 606 revenue recognition and eliminate manual WIP formula errors across active contracts.
General Contractors & MEP/Civil Subcontractors: Maintain a surety-ready WIP report to maximize bonding capacity and monitor job cash flow.
Construction CPA Auditors & Surety Bond Agents: Standardize client WIP submissions with a clean, self-balancing template.
Construction Project Managers & Senior Estimators: Review monthly Cost-to-Complete (ETC) forecasts and track gross margin performance from mobilization to closeout.

What’s Inside the Workbook (Tab-by-Tab Breakdown)

1

01_WIP_Over_Under_Schedule (14-Column Job-by-Job WIP Schedule)

Contains contractor & surety bonding header metadata, 5 portfolio KPI summary cards (Revised Contract Backlog, Earned Revenue, Progress Billings, Underbillings Asset, and Overbillings Liability), and a 10-job dynamic WIP table.

2

02_ASC606_Revenue_Journal (Automated Over/Under Billing Journal Entry)

Linked journal entry worksheet that pulls portfolio Underbillings (Col L) and Overbillings (Col M) to generate the exact month-end Debit/Credit entry to GL 1380 (CIEB Asset), GL 2380 (BIEC Liability), and GL 4190 (Revenue Adjustment).

3

03_Surety_and_ASC606_Guide (Formulas & Underwriter Red-Flag Guide)

Explains each ASC 606 WIP formula and details how surety bond underwriters evaluate overbillings, underbillings, and job profit fade.

Practitioner Tips & Best Practices

  • ✓
    Never Treat Cost-to-Complete (ETC) as a Plug Formula: The most common WIP mistake is setting Estimated Cost to Complete as (Original Budget - Cost to Date). Always require Project Managers to perform a fresh bottom-up forecast of remaining labor, material, and subcontract costs every month.
  • ✓
    Watch Out for Chronic Underbillings on Jobs Over 75% Complete: Surety underwriters view persistent underbillings late in a project as a major red flag—it often indicates unrecognised cost overruns (profit fade) or disputed change orders that the owner refuses to pay.
  • ✓
    Ensure Overbillings Are Backed by Actual Cash on Hand: While moderate overbilling (front-loading mobilization and early submittals) improves job cash flow, if your total Overbillings Liability exceeds your cash and Collectible AR, it signals 'job borrow'—using new jobs to pay old job bills.
  • ✓
    Recognize 100% of Projected Losses Immediately (GAAP Loss Provision): Under US GAAP ASC 606, if Total Estimated Cost (Column H) exceeds Revised Contract Value (Column E) on any job, 100% of the total projected loss must be accrued immediately in the current period, not prorated by % complete.

Frequently Asked Questions

How do you calculate Overbilling and Underbilling on a Construction WIP schedule?

First, calculate Earned Revenue to Date by multiplying the Revised Contract Value by the Cost-to-Cost % Complete (Cost to Date ÷ Total Estimated Cost). Next, compare Earned Revenue to Billed to Date: if Billed to Date > Earned Revenue, the difference is Overbilling (a Current Liability); if Earned Revenue > Billed to Date, the difference is Underbilling (a Current Asset).

Are Underbillings an asset or a liability on a construction balance sheet?

Underbillings (formally titled 'Costs and Estimated Earnings in Excess of Billings on Uncompleted Contracts' or CIEB) are recorded as a Current Contract Asset on the balance sheet because the contractor has performed and earned revenue for work that has not yet been billed to the project owner.

Are Overbillings an asset or a liability on a construction balance sheet?

Overbillings (formally titled 'Billings in Excess of Costs and Estimated Earnings on Uncompleted Contracts' or BIEC) are recorded as a Current Contract Liability (unearned/deferred revenue) because the contractor has billed the client ahead of physical cost completion and owes the remaining work.

Should Progress Billings to Date on the WIP schedule include or exclude retainage?

Under US GAAP construction accounting standards, Progress Billings to Date (Column K) must include 100% of gross approved progress billings (including the 5% or 10% retainage withheld by the owner), since retainage receivable is already recognized as a contract asset.

What is 'Profit Fade' on a Construction WIP report and why do sureties care?

Profit fade occurs when a project's estimated gross profit margin percentage declines month-over-month as Cost-to-Complete estimates rise. Surety underwriters monitor WIP schedules across consecutive quarters to verify that a contractor's initial bid estimates hold up during field execution.

Can I add more than 10 active construction projects to this Excel WIP template?

Yes. The workbook is 100% unlocked and macro-free. Simply insert additional rows above the Total row (Row 22) and copy the formulas in Columns E, H, I, J, L, M, and N down for as many active jobs as your company manages.
